Even a detailed project plan can run into a bottleneck. When several projects need the same specialist, approval, or test environment, work queues at that point while other teams wait. Bottlenecks in project management are not isolated delays. They limit the flow of every piece of work that depends on that stage, and in a multi-project environment one shared team can hold back projects whose own plans look fine.
This guide explains how to recognize a project bottleneck, confirm its cause with workload and workflow data, and choose practical ways to reduce its impact across multiple projects, including where AI helps and where it does not.
Key Takeaways:
- A bottleneck in project management is a resource or workflow stage where demand exceeds capacity, so ready work queues and the projects behind it slow down.
- In a multi-project environment, bottlenecks cause cascading delays, overload key specialists, and reduce throughput, even when average utilization looks healthy.
- To prevent bottlenecks, check skills and capacity before committing work, limit work in progress, watch queues as well as workloads, and forecast load.
- To resolve a bottleneck, confirm it with data, prioritize the work that passes through it, add capacity where it counts, and check that the queue did not just move.
- AI saves hours everywhere, but only hours saved at the bottleneck bring delivery dates forward.
What Is a Bottleneck in Project Management?
A bottleneck in project management is a resource or workflow stage where the demand for work is larger than the capacity available to process it. Ready work piles up in front of it, and everything downstream waits. In multi-project management, a bottleneck is more than a single delay: one or two shared teams can set the pace of every project that needs them.
In a multi-project organization, the bottleneck is usually a resource constraint: the specialists every project needs at the same time. It can also be an approval step, a test environment, or a piece of equipment. A late task on its own does not prove a bottleneck. A recurring queue at the same point does.
The key symptoms of a bottleneck include:
- Unfinished work piling up at the same stage
- People waiting for input from the same resources
- Long lead times and frequent delays downstream
- Overloaded teams or individuals
Treat these symptoms as signals to check, not as proof. A queue can be an intentional buffer, a one-week spike, or the result of a block further downstream. The section on how to identify bottlenecks shows how to confirm one with data.
Bottleneck vs. delay, constraint, and critical path
These terms are often used as synonyms, and the answer to "what is another word for bottleneck?" is usually "constraint" or "chokepoint". They describe different things:
- A delay is an outcome: a task or milestone finished later than planned. A bottleneck is one possible cause.
- A constraint is the broader term. In the Theory of Constraints it means whatever limits a system's output, and resource constraints in project management include budget, skills, equipment, and time. A bottleneck is the specific point where work queues because capacity there is short.
- The critical path is the longest chain of dependent tasks that determines a project's end date. It is a schedule concept, not "the most overloaded person". When shared resources are scarce, the bottleneck can change which path is critical.
Types of bottlenecks
The five types below are a practical classification, not an industry standard. Some are resource problems, others are workflow bottlenecks, and one situation can combine several.
Resource bottlenecks
A resource bottleneck appears when a person or resource group is assigned more work than they can complete in the time available. The typical case is a key specialist, such as a systems engineer or validation lead, needed by several projects at once. These performer-based bottlenecks are the most common type in multi-project environments.
Process bottlenecks
Process bottlenecks occur when a workflow stage takes longer than planned or sends work back. With repeated rework and incomplete handoffs, the next stage spends its time correcting inputs instead of processing new work.
Dependency bottlenecks
A dependency on its own is not a bottleneck. It becomes one when several tasks or projects wait for the same deliverable, and the team producing it lacks capacity. The waiting then cascades across every linked project.
Decision bottlenecks
Decision bottlenecks come from slow approvals. When every scope change needs the same person's sign-off, waiting for approval can take longer than the work itself. Unclear decision rights make it worse.
Technical bottlenecks
Technical bottlenecks occur when a tool, system, or environment limits the speed of work: a shared test environment with too few slots, a tool with too few licenses, or outdated equipment.
Examples of project bottlenecks
Five common project bottlenecks, the evidence that confirms each one, and a first intervention to evaluate. These are illustrative examples, not Epicflow customer cases.
|
Example |
Evidence to check |
First intervention to evaluate |
|---|---|---|
|
One engineering reviewer serves three projects |
The ready review queue is growing; available review capacity is below combined demand |
Protect review time, remove avoidable rework, assess a qualified second reviewer |
|
Every scope change needs one manager's approval |
Approval waiting time dominates elapsed time; decision rights are unclear |
Clarify authority and escalation; delegate within approved limits |
|
A shared test environment limits validation |
Tasks wait for the same slot; environments or qualified operators are unavailable |
Compare slot sequencing, setup reduction, and validated additional capacity |
|
Incomplete handoffs trigger repeated rework |
Items return to the previous stage; reviewer time is spent correcting missing inputs |
Define readiness and quality checks before the bottleneck stage |
|
Projects depend on one delayed external input |
Blocked work shares the same missing deliverable; downstream dates move |
Confirm the dependency owner, escalation path, and feasible alternative sequencing |
Note the last row: an external dependency can block work without being a capacity bottleneck. Confirm its impact before you treat it as one.
Why Are Bottlenecks Dangerous for Your Project Environment?
Multi-project environments are the most exposed to bottlenecks because projects share resources and depend on each other. When a shared engineering review group falls behind, dependent tasks in every project it serves wait, even though other people on those projects have time to spare. The effect spreads:
- Cascading delays push project due dates back.
- Overloaded specialists switch between projects, make more mistakes, and create rework.
- Delays and extra coordination increase costs.
- Lead times grow, throughput falls, and opportunities are missed.
At Epicflow, we see overload as the main cause of bottlenecks in a multi-project environment. That is why one of the core rules of our approach to resource management is "Make sure not a single resource is overloaded." It does not promise a portfolio without bottlenecks. It keeps them visible and small enough to manage.
What a bottleneck costs
Bottleneck time is worth more than any other time in the portfolio. An hour lost at the bottleneck is lost for every project waiting behind it, and an hour saved anywhere else moves no delivery date.
The arithmetic is simple. Twelve projects pass through a team that can finish one of them a month. Start all twelve at once and each takes about twelve months to land. Release four at a time and each finishes in about four. Same people, same capacity, value much sooner.
To put a price on a bottleneck, start with two numbers. The first is the overload: the hours of demand above the group's capacity, multiplied by the group's hourly rate. The second is larger and easier to miss: the cost of delay of every project waiting in the queue, such as revenue that arrives later, penalties, and invoiceable milestones that slip. Our guide to cost of delay shows how to calculate it with a worked example. If relieving the bottleneck costs less than the delay it removes, the relief pays for itself. Some readers know the per-day figure under Stephen Devaux's name for it, drag cost.
Example: a defense portfolio with hidden overload
The Dutch Ministry of Defense ran hundreds of projects at the same time, all treated as equally important. Engineers were assigned to many projects at once, and new projects started without a check against the capacity available. Work piled up around a few critical specialists. An Epicflow analysis found the portfolio 316 days delayed, with an overload equal to 15 full-time engineers in a resource group of 60.
Planning the work around that overload changed the forecast: the analysis indicated that due-date performance could rise from 24%, the customer's own figure, to 77%, without increasing headcount. Read the full Ministry of Defense case.
4 Important Steps to Prevent Bottlenecks in Projects
Don't overload your resources
Overload is the main source of resource bottlenecks, so prevention starts before work is committed. Make sure that:
- You perform resource capacity planning and plan each new project against the real capacity of your resources, including calendars, vacations, and commitments to other projects.
- You allocate work by competencies and availability, not by who is free first.
- You don't load people to 100% of their capacity. How much room each team needs depends on its work, so set it per team rather than with one rule for all.
- You don't assign large, time-consuming tasks to a single person when the work can be split.
- You agree on the intake of new work across projects, so several project managers do not commit the same specialists at once.
Monitor resource performance regularly
A typical mistake in a multi-project environment is to track project progress and overlook resource performance. Watch workload together with ready work, queues, blocked time, and completed output. A team can be fully booked while its queue keeps growing, and that is the early sign of a bottleneck. Review the causes with the team. The goal is to see the flow of work, not to rate individuals.
Control work in progress
If overload causes resource bottlenecks, too much work in progress causes overload. Running too many projects in parallel spreads people thin and slows everything down. To reduce work in progress:
- Perform portfolio rationalization to decide which projects are still worth the effort and which can be postponed or stopped. This frees capacity for the most valuable initiatives.
- Limit the start of new work rather than piling more onto active tasks. Agree on work-in-progress limits that fit your workflow instead of copying a fixed number.
- Make sure team members know task priorities. Clear priorities reduce multitasking and keep the bottleneck supplied with work that is ready to start.
Take a proactive management approach
A proactive approach means forecasting problems instead of firefighting them. Forecast the future workload of your resources and look for periods of overload: that is where bottlenecks are likely to form. Then balance workload across projects in advance. Scenario analysis lets you test the options before you commit: reassign work, reschedule projects, or move a due date. A forecast is only as good as its data, so keep availability, skills, and proposed projects up to date.
How to Identify Bottlenecks in Project Management: 5 Data Checks
Start with the queue, not with the busiest person. Bottleneck identification means proving where a project bottleneck sits and why work waits there, across every project that uses the same resource. These five checks make up a practical bottleneck analysis:
- Map the workflow and shared resources. Choose the scope and period. Draw the handoffs, approval gates, and resource groups that several projects share.
- Check where ready work queues. Separate work that is ready to start from work that is blocked or missing inputs. Measure how much ready work waits and how old the oldest items are.
- Compare demand with effective capacity. Use the same units and period for both. Effective capacity is what remains after calendars, other commitments, and rework. Do not compare raw task counts of different sizes.
- Confirm the cause with the team. Check approvals, input quality, dependencies, tools, and interruptions. The busiest person or the longest task is not always the bottleneck.
- Verify the effect on end-to-end flow. Relieving a real bottleneck improves delivery downstream. If the queue just moves to the next team, you found a symptom, not the source. Name an owner, record a baseline, and set a review date.

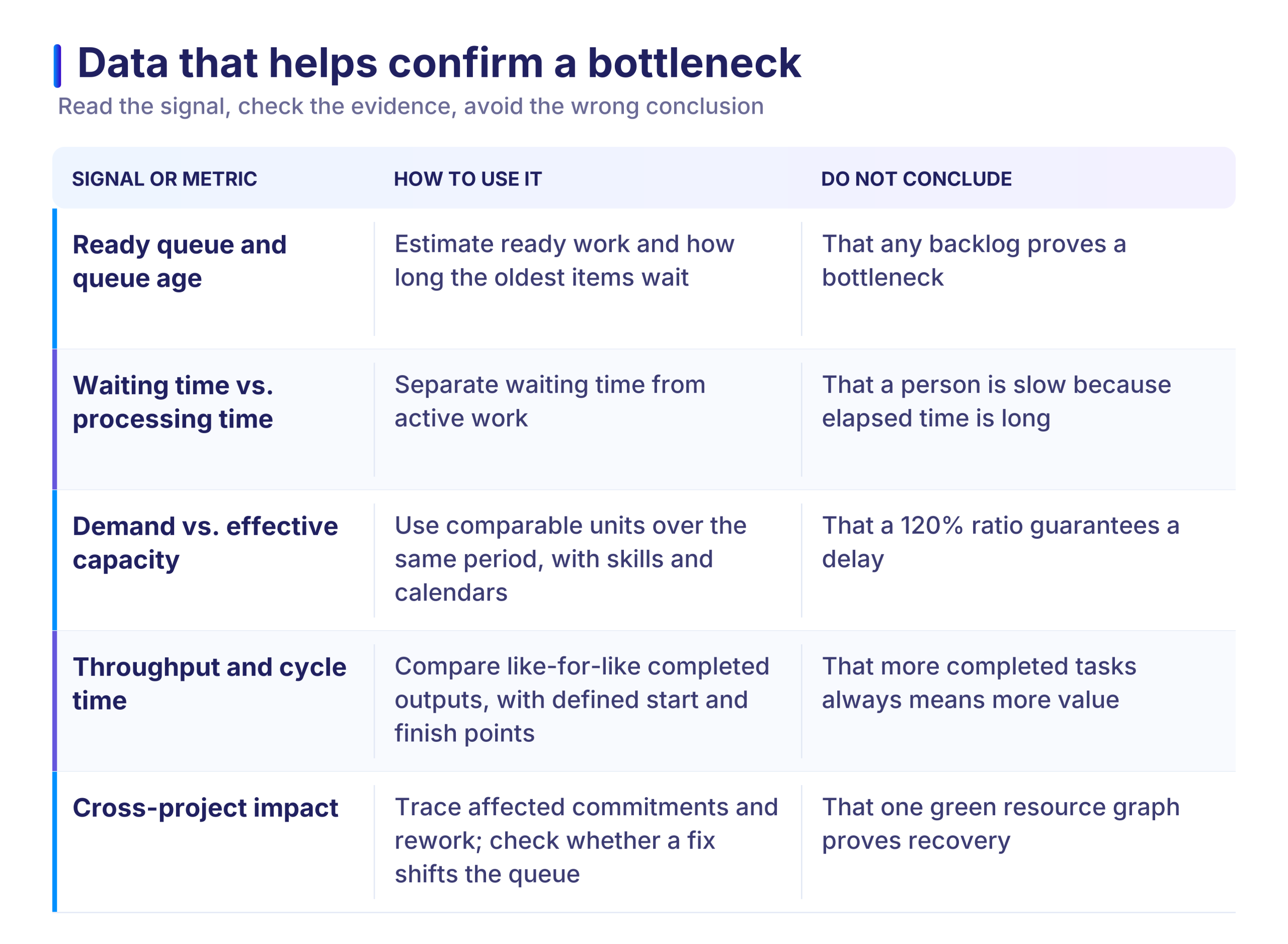

Data that helps confirm a bottleneck
Much of this data comes from task timestamps, workflow logs, and conversations with the team, not from one report.
Illustrative example: one review group, three projects
This is an illustrative example, not customer results. One engineering review group serves three projects. All inputs are ready, and effort is estimated in comparable person-hours.
| Parameter | Value |
|---|---|
| Effective review capacity | 30 review hours a week, after other commitments and absences |
| Ready demand from projects A, B, and C | 15 + 12 + 9 = 36 review hours a week |
| Capacity gap | 36 - 30 = 6 review hours a week |
| Demand-to-capacity ratio | 36 / 30 = 1.20, or 120% of effective capacity |
The six-hour gap makes the queue grow every week, even if every project manager considers their own request reasonable. That is six more hours of work in the queue each week, not six hours of delay for each project.

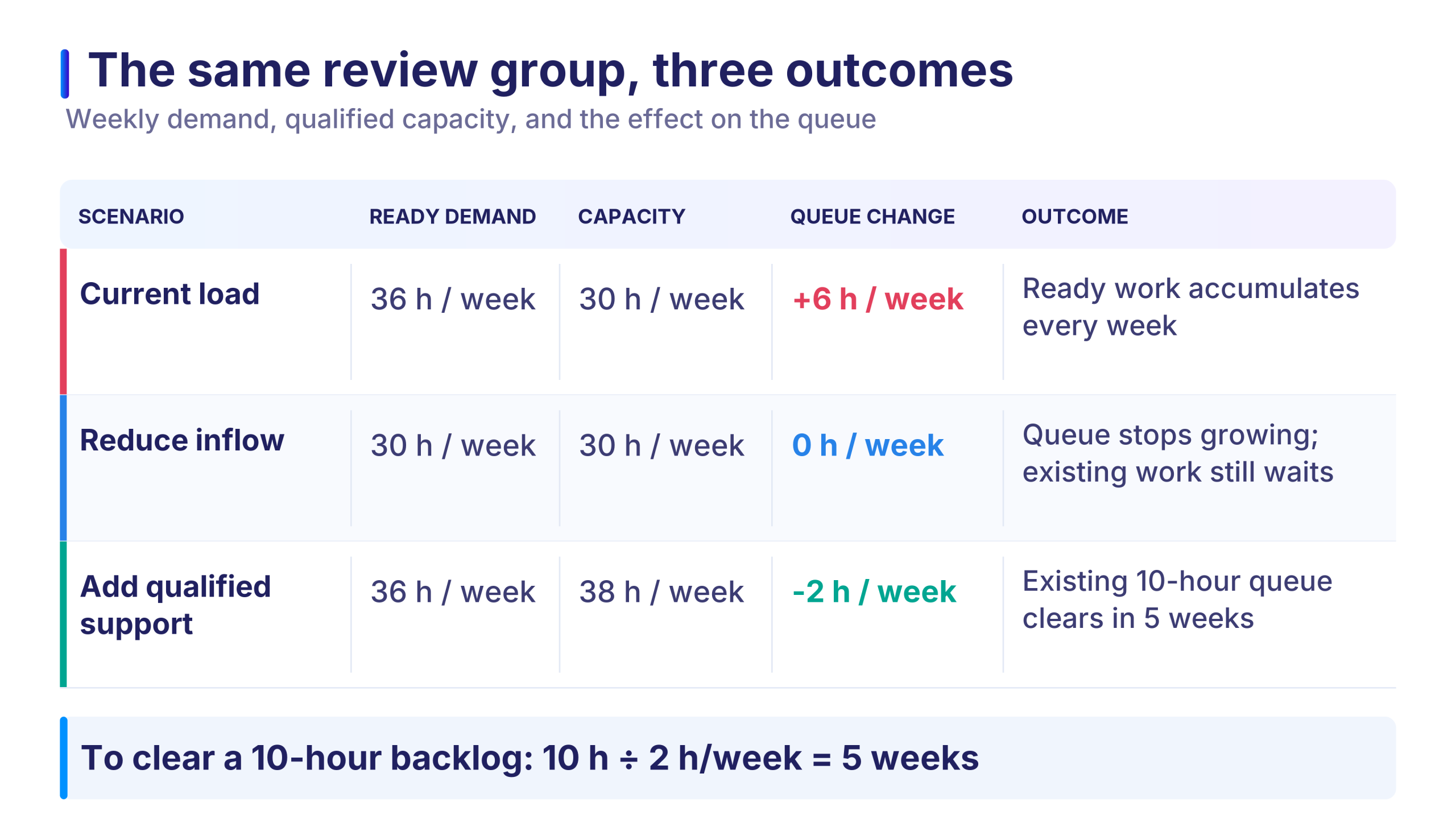

Two scenarios show the difference between stopping the growth and clearing the queue:
- Reduce inflow. Move six hours of new work to a later period. Demand falls to 30 and the queue stops growing, but the work already waiting stays. Check the commitments behind the work you moved.
- Add qualified support. Add 8 effective review hours a week. Capacity rises to 38 against demand of 36, leaving 2 hours a week for the queue. An existing queue of 10 review hours takes 10 / 2 = 5 weeks to clear, if nothing else changes. A real second reviewer also needs the right skills, authorization, and onboarding.
The example also shows what does not work. Adding developers upstream does not fix a shortage of reviewers. It sends more ready work to the review queue and makes it grow faster.
System bottleneck vs. symptom bottleneck
Two overloaded groups are often one problem. A system bottleneck usually sits upstream: work passes through it before it reaches anyone else. A symptom bottleneck appears downstream because the system bottleneck was left unmanaged, for example when delayed work reaches the next team in bursts.
To tell them apart, look at timing. The group whose overload started first is usually the source. Relieve it, and the downstream overload often eases on its own. Chase the symptom, and the next one appears.
How to Manage Bottlenecks?
Even well-run multi-project environments have bottlenecks, because demand and capacity keep changing. Effective bottleneck management is a cycle of action and review.
1. Identify the bottleneck.
Confirm the bottleneck with the five data checks above, using your project management tools and dashboards. Find the overloaded resource or group, the projects and tasks that create the overload, and the stage where work piles up. Name an owner and agree on the scope before anyone acts.
2. Prioritize work based on the bottleneck.
Assess the projects in execution: business value, due dates, readiness, and how much bottleneck time each one needs. Give the bottleneck's time to the work that returns the most for it, and reschedule lower-value work where possible. Protect that time: limit switching between projects and send the bottleneck only work with complete inputs.
3. Reallocate resources.

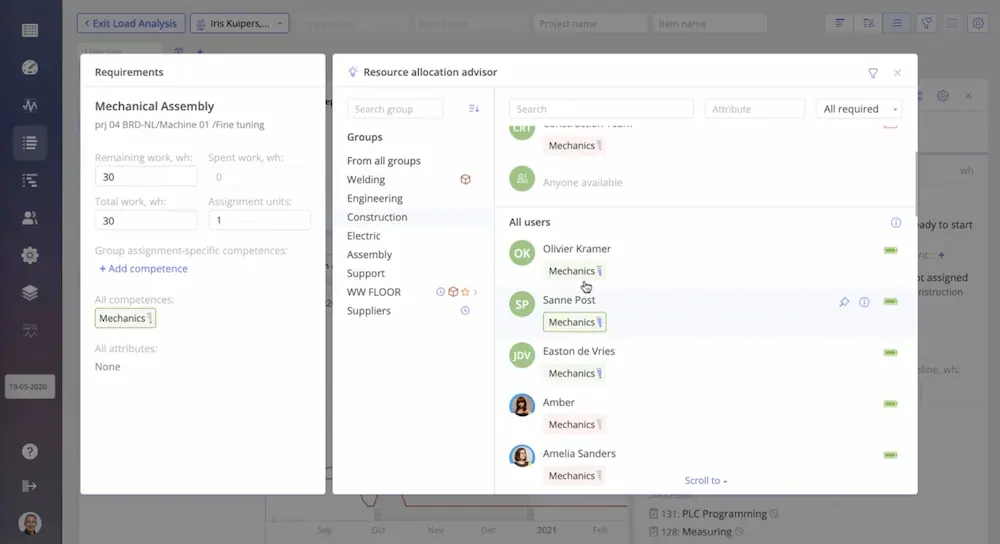

Once priorities are set, move capacity to where it counts. Check skills, authorization, and availability first: not every free person can replace a certified specialist. Options include delegating suitable checks, moving preparation and rework away from the bottleneck, cross-training, and adding capacity, whether people or AI.
4. Perform scenario analysis.
Before you commit, compare options in scenario analysis: postponing or resequencing projects, qualified reassignment, and adding capacity or changing the process. Look at the effect on every project, not only the one you want to rescue. Scenario analysis compares outcomes under the assumptions you set; the decision stays yours.
5. Monitor and adjust continuously.
Check queue age, waiting time, throughput, rework, and the affected milestones over a comparable period. A green utilization chart is not proof of success. When one bottleneck is relieved, the next one appears, and it usually shifts gradually as demand changes rather than jumping from team to team. Review the portfolio regularly to see where the pressure is building next.
The Theory of Constraints view
The five steps above echo Eliyahu Goldratt's Theory of Constraints, which has its own five focusing steps: identify the constraint, exploit it, subordinate everything else to it, elevate it, and repeat. "Exploit" means making the best use of the constraint's capacity, not making people work without rest. Critical chain project management applies the same thinking to project schedules.
Effective bottleneck management is much easier with software built for multiple projects. Before that, one more lever has changed recently: AI.
How to Use AI to Relieve Project Bottlenecks
Your AI is making everyone faster. Nothing is finishing sooner. This is the project bottleneck problem again. AI saves hours across the organization, but delivery dates only move when hours are saved at the bottleneck. Go back to the review example: if AI helps developers produce work faster, more ready work reaches the review group, and its queue grows faster.
So the question is not where AI can save time. It is where AI can take work off the bottleneck.
Three tests before you point AI at a bottleneck
- Is delivery waiting on it? The work sits in the queue of a scarce specialist team, an approval, or a knowledge holder that other work depends on.
- Does the wait cost real money? The projects behind the queue carry a cost of delay you can name.
- Can AI do the work to a standard a person can check and sign off? The task is bounded, its output is reviewable, and someone accountable approves it.
Most AI use cases fail the first test. Work that passes all three usually supports the bottleneck rather than replacing it: preparing evidence and documents before a review, comparing requirements against a specification, sorting incoming risks or change requests, or drafting test data. The specialist keeps the judgment and spends less time on preparation.
Count the review time too. If the bottleneck team has to check the AI's output, that time comes out of the same capacity. A review that takes back half the time saved takes back half the value.
Plan AI capacity like any other resource
Treat an AI resource the way you treat a person on the plan: with capacity, a rate, assigned work, and a person who signs off its output. Test the change before you commit to it. Did the projects behind the queue get earlier dates? Did the bottleneck shift to another team? Judge the AI by the dates it moved, not by how busy it was.
This also tells you where AI should go next. When the current bottleneck is relieved, the next one appears, and the AI should follow it.
Managing Bottlenecks with Epicflow
A workflow board shows where work is waiting, but rarely how future demand from many projects lands on the same people. Bottleneck management software for multi-project environments has to show which team holds the portfolio back, which projects and tasks cause it, and what a change would do to every date before you make it.
Epicflow is multi-project and resource management software built for that. It forecasts every project from the people you actually have, so a bottleneck shows up months before a status report turns red. Here is how its bottleneck analysis tools work together.
How to find a bottleneck with Epicflow

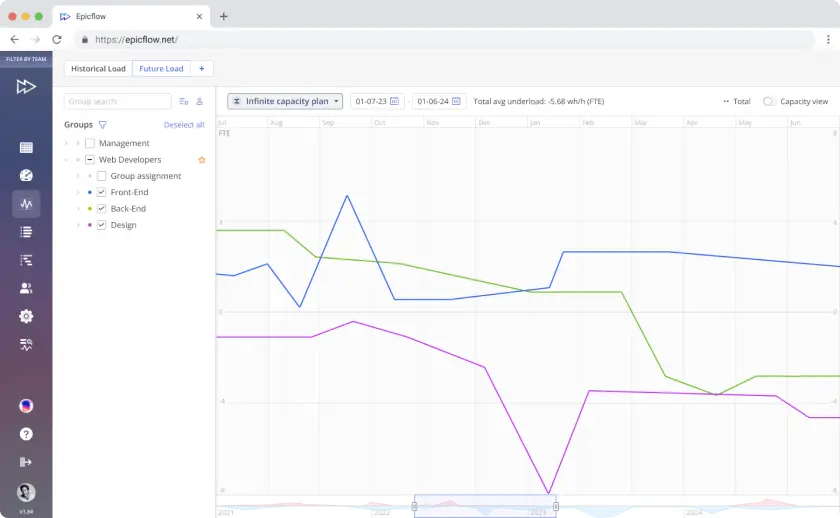

The Future Load Graph shows the forecast workload of a resource or resource group against its capacity, in full-time equivalents (FTE), for the period you select. The zero line is capacity. When the load stays above it, the group is overloaded and a bottleneck is forming. When it stays below, the group has room for more work.
How to find the source of a bottleneck
Epicflow team has developed three essential features that will help you analyze the workload of your resources, predict and avoid bottlenecks: Load Analysis, Inactive Analysis, and Bottleneck Analysis. All of them are available on the Future Load graph, which in turn now can be opened either from the Pipeline or the Task List’s Group tab. From both places you can analyze the load of individual resources and resource groups and check the projects and tasks that are causing the overload. What’s important, the analysis is carried out automatically, and you don’t have to make any calculations. It can be done with a few clicks. Let’s consider these features in more detail.

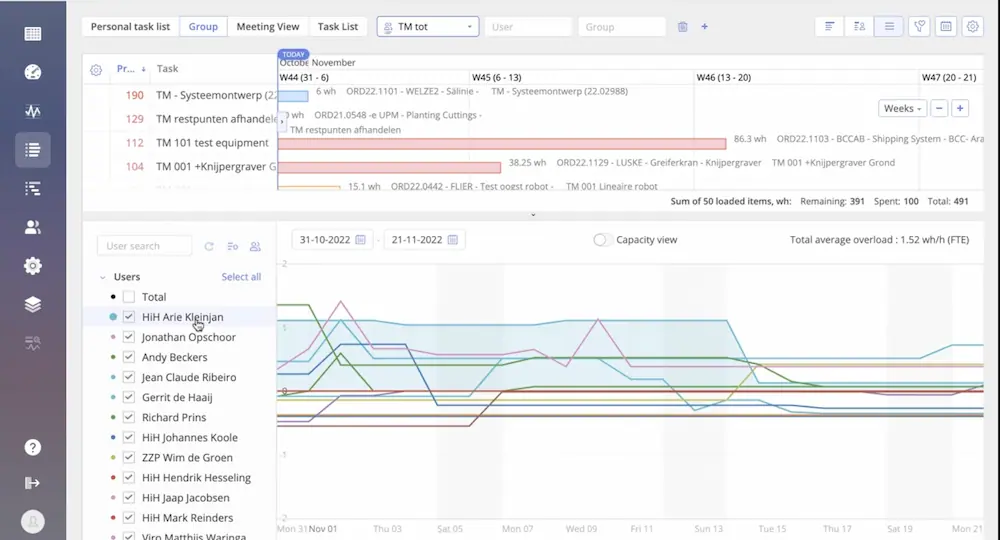

Load Analysis

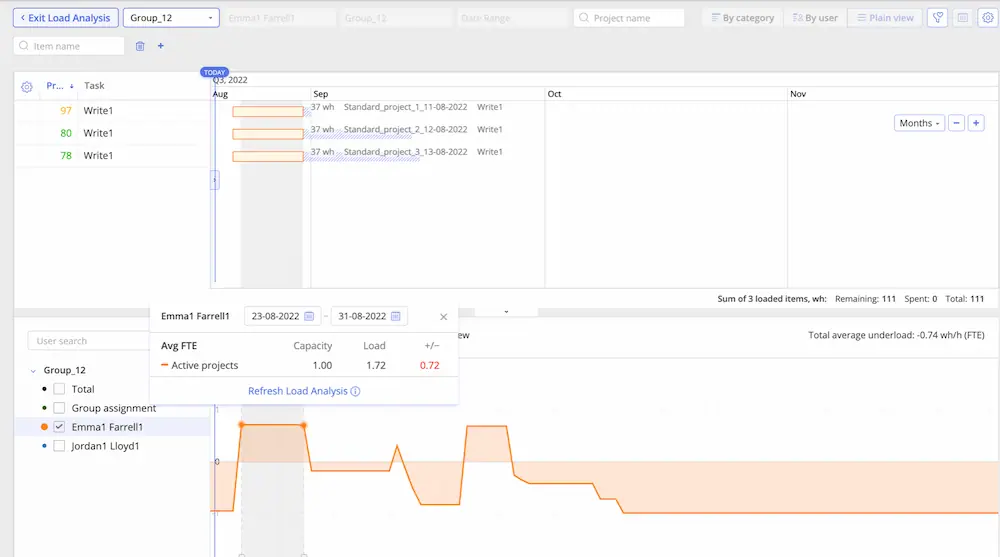

Select a group and the overloaded period, and Load Analysis lists the tasks and projects that create the load, with the shortfall in FTE. From there you can move a milestone or open the Task Card, where the Resource Allocation Advisor suggests people with the required competencies and availability, inside or outside the group. The Advisor recommends; the manager decides.
Bottleneck Analysis
When many groups are on the graph, it is hard to tell which one limits the portfolio. Bottleneck Analysis ranks resource groups, or individual people, by average overload or peak load in the period you choose, so the main bottleneck sorts to the top. Run Load Analysis on the top group to see what is overloading it, then decide: move a milestone, reassign a task, or add capacity.
To put a price on what you find, multiply the overload hours by the group's hourly rate, and compare it with the delay the overload causes in the projects that wait.
Inactive Project Load Analysis

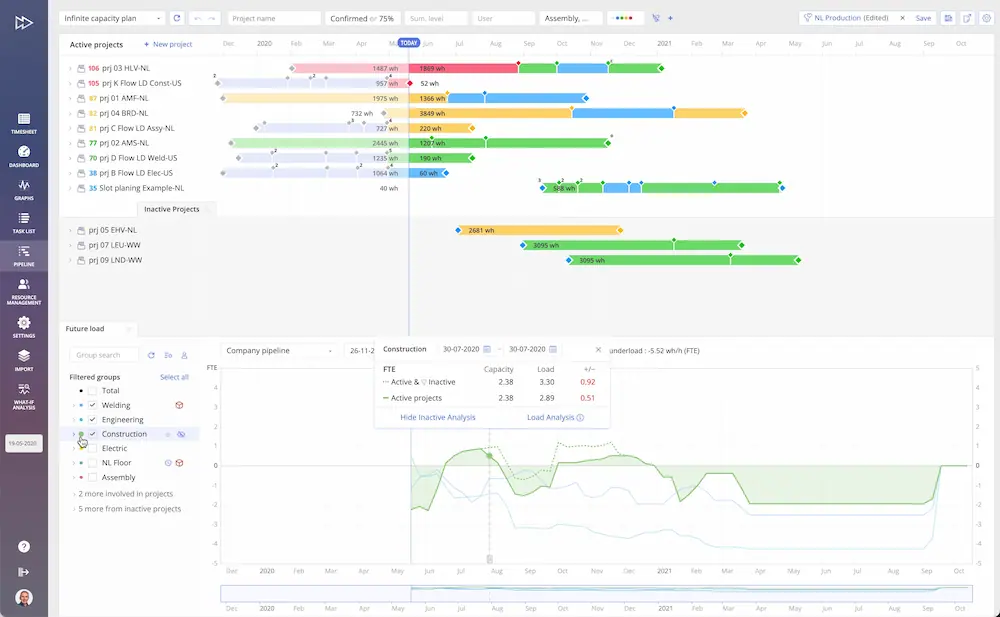

Many bottlenecks are created when new projects start. Inactive Project Load Analysis shows how loaded your resources would be if you started projects that are still inactive; their load appears as a dashed line. In the example below, the selected group is 0.51 FTE short with active projects alone, and starting the inactive projects would widen the gap to 0.92 FTE. Before you start them, check which tasks would overload the group and decide whether to move milestones, reassign tasks, or add capacity.
Test the change before you commit
In What-If Analysis, available on the Enterprise plan, you can resequence projects, pause what can wait, move people, or add capacity, and see the new dates for every project. Nothing in the live plan changes until you decide. AI capacity is planned the same way, as an AI resource with capacity, a rate, and dates, whether it runs on your own agent platform or on EpicStaff, which is included with Epicflow.
Send us your project list. We build a model of your own portfolio and show you, in one session, the team that holds it back and what two or three changes to the plan would do to your dates. Request a demo.
Frequently Asked Questions
What are bottlenecks in project management?
Bottlenecks in project management are resources or workflow stages whose limited capacity restricts the flow of dependent work. They show up as ready tasks waiting at the same point, recurring delays, or overloaded specialist groups shared by several projects.
What are examples of bottlenecks?
Examples include one engineer reviewing work for several projects, a manager who must approve every change, a shared test environment with too few slots, and handoffs that send incomplete work back for correction.
How to avoid bottlenecks in project management?
Check skills and available capacity before committing work, limit work in progress, prepare inputs before the bottleneck stage, clarify who approves what, and monitor queues across projects. This reduces the risk; it does not remove every disruption.
What is bottleneck management?
Bottleneck management is the ongoing work of finding the bottleneck that limits flow, choosing actions to reduce its impact, and checking the result. It combines workflow data, capacity decisions, prioritization, and regular review as demand changes.
What are the 4 principles of bottleneck management?
There is no single universal four-principle standard. A practical four-part summary is: identify the bottleneck, make the best use of its capacity, align other work with it, and review the result. It is not the same as the Theory of Constraints' five focusing steps: identify, exploit, subordinate, elevate, and repeat.
How to do bottleneck analysis?
Map the workflow and shared resources, examine ready-work queues and waiting time, compare demand with effective capacity, and confirm the cause with the team. Then test a targeted change and check whether end-to-end flow improves.
How to identify bottlenecks in project management?
Look for repeated queues, aging ready work, downstream teams waiting for the same input, and demand that exceeds the capacity of a required resource. Confirm the pattern with data over a defined period.
What is a bottleneck in Agile?
In Agile delivery, a bottleneck is a stage or resource that limits the flow of work through the team's process, such as review or testing. It may also be a specialist or approval shared with other teams.
What is a bottleneck in business?
A business bottleneck is a point in a workflow whose limited capacity restricts the output of the whole process. In project-based organizations, the same specialist, decision-maker, or technical environment can become a bottleneck for several projects at once.
Can AI help reduce bottlenecks in project management?
Yes, when it takes work off the bottleneck itself. AI that saves hours elsewhere moves no delivery date and can even make the queue grow. Use AI where delivery waits, where the wait costs money, and where a person can check and sign off the output.
